BHP West Musgrave Data Centres
In January 2023, XCircle was awarded a highly sought-after contract to design, supply, and install two 40kW, 6-rack modular data centres for BHP West Musgrave. The contract was the culmination of a rigorous tender process thot began in June 2022, which saw multiple companies compete for the opportunity to work with BHP.
XCircle impressed the selection committee with their innovative approach, advanced technology, and ability to deliver the project within the specified timeframe and budget.
◎ All design, engineering, manufacturing and fit of two modular data centres to be completed by June 2023.
◎ Supply and installation of a 2N, 40kW UPS and battery system with 20 mins autonomy and including electrical distribution to equipment racks in an XCircle custom designed and manufactured UPS rack.

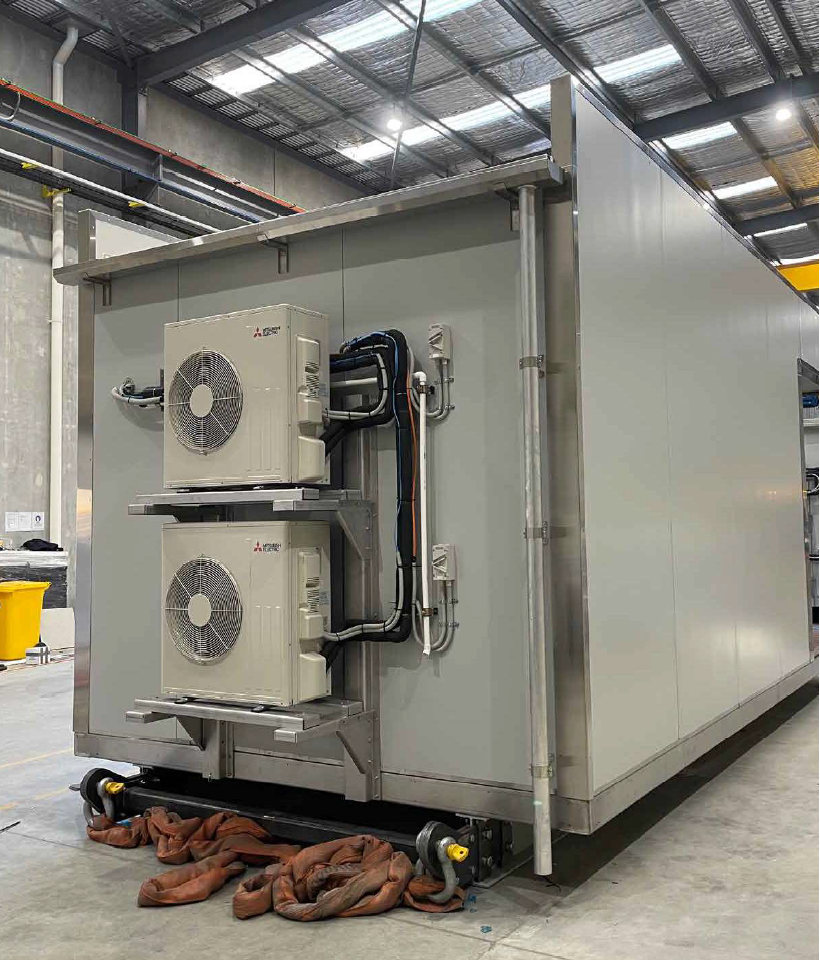

◎ Supply and installation of 40kW of in-row cooling in N+1 including integrated outdoor condenser mounting to allow for transport in-situ.
◎ Supply and installation of six (6) 600mm wide XCircle equipment racks and one (1) 800mm wide XCircle ODF rack.
◎ Design, supply and installation of fibre structured cabling system in conjunction with Codecom.
◎ Provision for underfloor cabling and piping using XCircIe*s raised floor design solution. Supply and installation of fire detection including VESDA, and inert gas suppression system.
◎ Design, supply and installation of a full monitoring and reporting system including equipment monitoring, environmental monitoring and water leak detection.
◎ Modular construction structurally certified to withstand Wind Region A.
◎ C3 paint coat system to all steel components
◎ Fire resistant to FRL 120/120/120 for the entire data centre including doors.
◎ CCTV surveillance and access control system.
◎ Airlock to prevent dust and contaminant ingress into the main equipment area.
◎ Full factory acceptance testing, and certification prior to delivery.
◎ Delivery, installation, commissioning and testing on site.
◎ Support and maintenance of the data centre equipment for 12 months.
◎ Site civil works including all concrete pads and plinths, including integration of underground electrical and fibre reticulation.
